Knoxville

Oak Ridge Preps Alpha‑4 Building For Demolition

AI Assisted Icon
Published on March 05, 2026
Oak Ridge Preps Alpha‑4 Building For DemolitionSource: U.S. Department of Energy

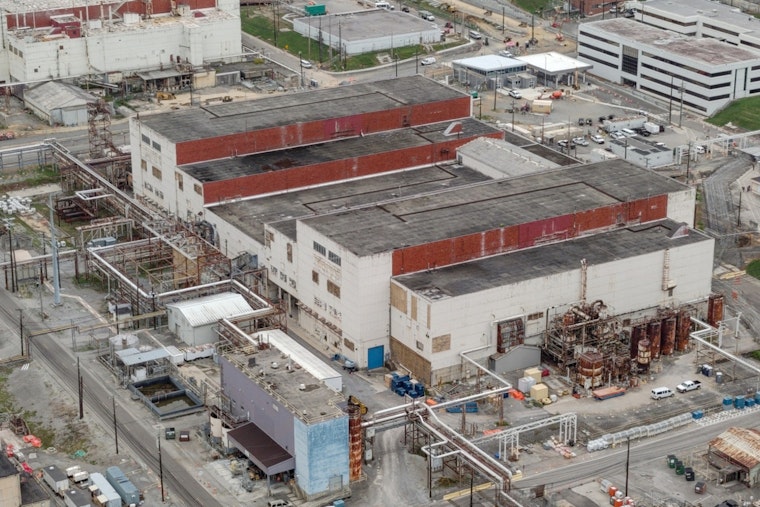

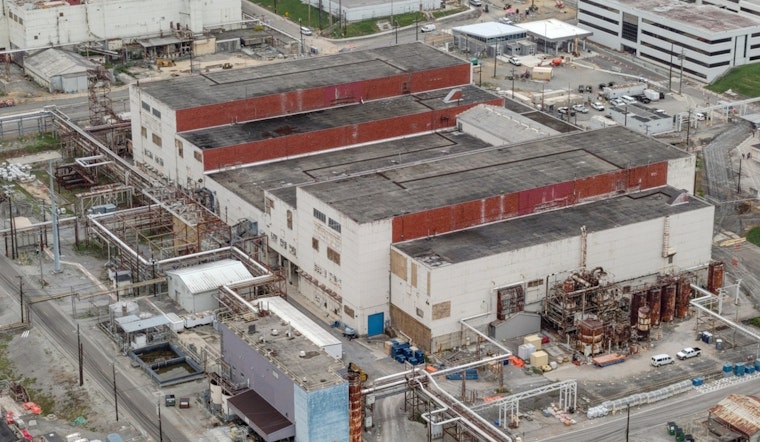

Crews at the Y-12 National Security Complex in Oak Ridge have pushed the massive Alpha-4 building into the early stages of cleanup ahead of demolition, according to federal officials and contractors. The Manhattan Project-era giant sprawls across roughly 13 acres and has now been placed in a “cold and dark” status while teams strip out classified equipment and other hazards. At the top of the to-do list is stabilizing and removing large pockets of elemental mercury left over from mid-century lithium-separation work.

In a March 3 post, the Department of Energy's Oak Ridge Office of Environmental Management reported that Alpha-4 covers about 510,000 square feet, and experts estimate nearly 450,000 pounds of mercury remain in equipment, the building structure and surrounding soils. The DOE post notes that crews have moved into a sanitization stage, removing classified systems so they can move on to detailed characterization and full deactivation. Sanitization is projected to wrap in 2028. “Preparing a facility for demolition is always the lengthiest part of the process,” Federal Project Director Morgan Carden said in the statement.

Mercury Cleanup Is the Biggest Obstacle

Cleanup contractor United Cleanup Oak Ridge (UCOR) reports that crews have sorted and segmented 447 legacy containers and are tackling more than 4,000 gallons of elemental mercury still inside Alpha-4, an amount the contractor says must be stabilized before any wrecking crews move in. UCOR says workers are using absorptive materials and targeted containment fixes to keep vapors in check while they package hazardous waste for off-site disposal. The idea is to limit the chance of any releases into nearby creeks and neighborhoods as the project ramps up.

Small Innovations Trimmed the Schedule and Costs

Project leaders say a mix of procedural tweaks and equipment upgrades has already shaved nearly two years off the cleanup schedule and saved about $16.3 million. Nuclear Engineering International reported that teams are using drum-crushing and declassification efficiencies to cut handling time and disposal volumes, which in turn speeds up shipments and lowers worker risk. Officials say all of these methods were vetted to ensure they meet safety and regulatory requirements.

What’s Next for Alpha-4 and the Y-12 Site

After sanitization, crews will move into characterization, waste removal, venting and purging of process lines, followed by full-scale deactivation ahead of demolition, according to coverage from WBIR. The station also reports that the Alpha-4 work is being coordinated with other major infrastructure efforts, including a new Mercury Treatment Facility and rerouting of utilities, so Y-12 can keep operating while cleanup moves forward. Officials say they plan to keep posting milestone updates on Department of Energy and contractor channels as the project advances.
