Sacramento

Truckee I-80 Bridge Swap Promises Smoother Rides, Slows Holiday Traffic First

AI Assisted Icon
Published on December 12, 2025
Truckee I-80 Bridge Swap Promises Smoother Rides, Slows Holiday Traffic FirstSource: Caltrans

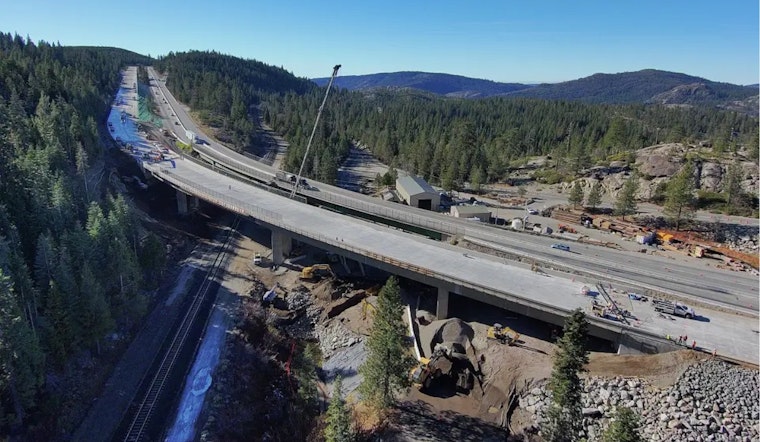

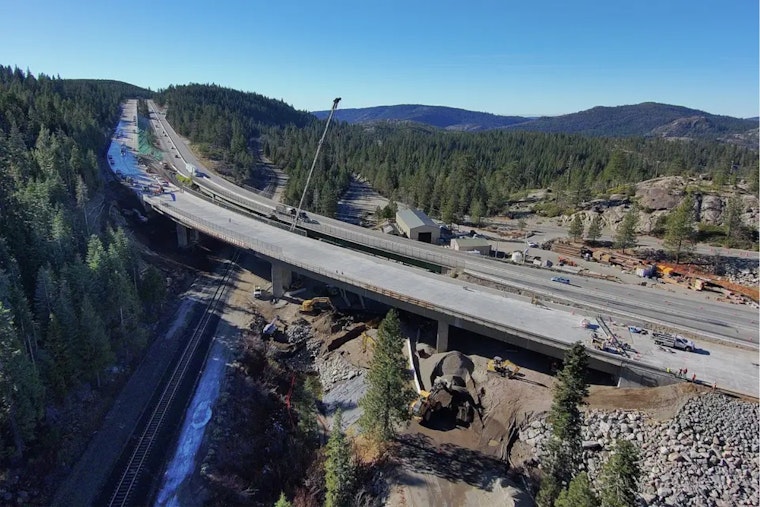

Holiday drivers headed for Truckee and the Tahoe basin are in for a tradeoff this week: a brand-new Interstate 80 bridge span near Lake Spaulding, and some very real traffic pain while Caltrans shifts cars and trucks onto it.

Eastbound traffic on I-80 will be moved onto the new bridge as part of an ongoing replacement project, and the work will squeeze both directions of the freeway into fewer lanes. The result is expected to be slow-and-go conditions and longer trip times, with officials planning to have two travel lanes restored in each direction by Friday afternoon, December 19.

In a District 3 news release, Caltrans said crews will reduce both eastbound and westbound I-80 to a single lane in each direction starting Sunday at 7 p.m. One lane of eastbound traffic is scheduled to shift onto the new bridge span by Tuesday, December 16. The agency warned that motorists could see delays of up to 30 minutes and said both directions are expected to return to two lanes by 5 p.m. on Friday, December 19.

As reported by SFGATE, the Yuba Pass Separation Overhead project began in 2022 and is centered about 25 miles west of Truckee at the I-80 and State Route 20 junction. The outlet notes that the westbound span is slated for reconstruction in the spring and that this week’s lane closures could add roughly 30 minutes to a typical drive through the Sierra corridor.

What the project includes

The broader effort calls for replacing and widening two overhead bridges, building median retaining walls, rehabilitating drainage systems and installing roadway weather-information systems. Caltrans has said the work is needed to boost freight capacity and improve safety along the busy corridor.

The total project cost is estimated at about $112 million, according to the agency’s project page, with construction scheduled to continue through winter 2027. Caltrans.

Why the bridges needed replacement

State filings and the environmental review describe the existing structures as having severe transverse and longitudinal cracking, spalling concrete and elevated chloride levels. The spans were given a “poor health rating” and were not able to meet load-carrying requirements for some freight trucks, according to the documents.

Those structural problems were cited as the main reason Caltrans opted to replace the bridges instead of continuing with repairs, according to the project’s California Environmental Quality Act documents. CEQA.

When you will see changes

Drivers will feel the impact starting Sunday evening, when traffic is set to be reduced to one lane in each direction. By Tuesday, one eastbound lane should be routed onto the new span. Those extended closures are expected to stay in place through the week, with two lanes in each direction planned to reopen Friday afternoon.

Coverage of Caltrans advisories has emphasized the timing of the shift and warned that drivers should expect slowdowns while crews move temporary barriers and complete tie-ins to connect the new bridge to the existing roadway.

Plan your trip

Motorists can expect reduced speeds and an increased California Highway Patrol presence in the work zone. Caltrans is urging travelers to check real-time conditions on its QuickMap tool and to allow extra time for trips to Tahoe or Truckee.

Detours and temporary ramp closures will be used at times so crews can move equipment and tie the new span into the freeway. The agency notes that the schedule could shift if weather or material deliveries cause delays.
